A primary metric is the single measurement a Six Sigma project uses to define success. It ties directly to the process output the team is trying to improve, and the project team must be able to influence it through the changes they make. A project has exactly one primary metric, even though the process it studies may generate dozens of measurable numbers.

Secondary metrics track related factors that should not get worse while the primary metric improves. A common example: a call center project uses average handle time as its primary metric, while tracking customer satisfaction as a secondary metric, to confirm the team is not just rushing calls to hit a number.

Quick-Reference Table: Metric Types in a Six Sigma Project

Metric TypeWhat It TracksHow Many Per Project
Primary metricThe core output the project aims to improveExactly one
Secondary metricA related factor that must not worsen as the primary metric improvesOne or more
Consequential metricA downstream business result the primary metric is expected to influenceZero or more

Key Takeaways

  • A project has exactly one primary metric. Multiple primary metrics dilute focus and make trade-off decisions unclear.
  • The team must be able to directly influence the primary metric. A metric outside the project’s control cannot serve as its success measure.
  • Secondary metrics act as guardrails. They confirm the team is not improving the primary metric at the expense of something else that matters.
  • A consequential metric shows the business impact one level removed. Revenue or customer retention often falls into this category.
  • A weak primary metric is a common cause of project failure. Choosing a metric too broad, too vague, or too far removed from the team’s actual control undermines the whole project.
  • The primary metric belongs in the project charter from day one. It should never get chosen after the project is already underway.

What Is a Primary Metric?

A primary metric is the specific, measurable output a Six Sigma project uses to prove whether it succeeded. It comes directly from the process the team is improving, and the team must have the ability to change it through their project’s actions.

Common primary metrics include defect rate, first pass yield, cycle time, and cost per unit. What makes a metric qualify as “primary” is not the specific number itself. It is the role that number plays: it is the one measurement the entire project gets judged against.

Kevin Clay

Public, Onsite, Virtual, and Online Six Sigma Certification Training!

  • We are accredited by the IASSC.
  • Live Public Training at 52 Sites.
  • Live Virtual Training.
  • Onsite Training (at your organization).
  • Interactive Online (self-paced) training,

The Three Metric Types Every Project Needs

Most articles on this topic stop at defining “primary metric” alone. A complete understanding requires seeing how it relates to two other metric types that appear in the same project.

Primary Metric

The core output the project directly targets. A project has exactly one.

Secondary Metric

A related measurement that must not get worse while the primary metric improves. Secondary metrics act as guardrails against unintended consequences.

Consequential Metric

A downstream business result the primary metric is expected to eventually influence, like revenue, customer retention, or market share. Consequential metrics sit one step removed from the project’s direct control, which is exactly why they cannot serve as the primary metric itself.

Metric TypeExampleWhy It Serves This Role
PrimaryAverage call handle timeDirectly measured, directly controlled by the project team
SecondaryCustomer satisfaction scoreMust not drop while handle time improves
ConsequentialCustomer retention rateInfluenced by handle time and satisfaction together, but too indirect to serve as the primary target

Also Read: Abbott Six Sigma Case Study: Sigma Metrics in Diagnostics

Why a Project Needs Exactly One Primary Metric

Multiple primary metrics create a hidden conflict. If a team tries to optimize both cycle time and defect rate as co-equal primary metrics, they eventually face a trade-off: speeding up the process to cut cycle time can raise the defect rate.

Naming one metric as primary forces the team to make that trade-off explicit, using the second metric as a secondary guardrail instead of a competing goal. This does not mean the second metric gets ignored. It means the team tracks it to confirm the primary metric’s improvement did not come at that metric’s expense.

The Three Requirements of a Strong Primary Metric

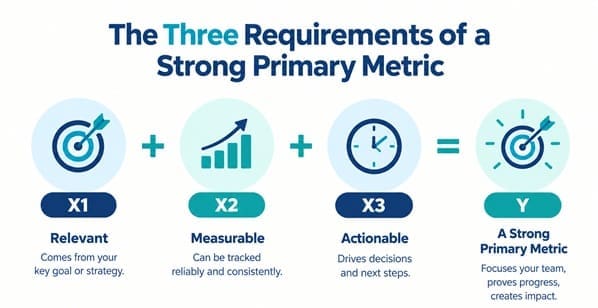

Three-Requirement Primary Metric Formula
Three-Requirement Primary Metric Formula

Not every measurable number qualifies as a good primary metric. A strong one meets three requirements.

  1. It connects directly to customer or business value. A metric disconnected from what the customer actually experiences risks optimizing something nobody cares about.
  2. The project team can directly influence it. A metric controlled mainly by factors outside the team’s project scope cannot measure that team’s specific improvement work.
  3. It can be measured consistently and objectively. A vague standard like “good quality” cannot function as a primary metric until it gets converted into a specific, countable, or measurable value.

This third requirement is where the classic Y = f(X) framework applies. The primary metric is the project’s Y, the output being measured. The X factors are the process inputs the team investigates and adjusts during the Analyze and Improve steps. A weak primary metric usually traces back to skipping this connection, choosing a Y that no clear X factors can realistically move.

How to Select the Right Primary Metric: A Step-by-Step Process

Choosing the Right Variability Measure
Choosing the Right Variability Measure
  1. Start from the project’s problem statement. The primary metric should measure the exact gap described in that statement, not a related but different issue.
  2. Confirm the metric ties to voice of customer data. A primary metric disconnected from what customers or downstream users actually care about risks solving the wrong problem.
  3. Check whether the team can influence it. If the metric depends heavily on factors the team’s project scope cannot touch, either narrow the scope or choose a different metric.
  4. Identify at least one secondary metric as a guardrail. This protects against a narrow optimization that damages something else that matters.
  5. Establish a baseline before starting. A primary metric without a documented starting value cannot later prove improvement occurred.
  6. Lock the metric into the project charter. Changing the primary metric mid-project, without a clear and documented reason, undermines the project’s credibility.

Also Read: Parametric Estimation

A Worked Example: Selecting a Primary Metric for an Ink Batching Process

A manufacturer produces liquid ink batches for screen printing. Batches mixed incorrectly generate rework and scrap costs.

Step 1: Define the problem. Batches frequently require rework, adding cost and delaying delivery.

Step 2: Consider candidate metrics.

Candidate MetricTies to Customer Value?Team Can Influence?Verdict
First pass yield (percent of batches correct on the first attempt)YesYesSelected as primary metric
Total plant revenueIndirectlyNo, too many outside factorsRejected, too consequential
Customer satisfaction scoreYesPartiallySelected as secondary metric

Step 3: Set the baseline. The plant currently runs a 78% first pass yield. The project targets 92%.

Step 4: Track a secondary metric. Customer satisfaction scores get tracked throughout the project, confirming the push for higher first pass yield doesn’t introduce new quality complaints from faster, less careful mixing.

This structure gives the project a clear, defensible way to prove success once complete, while protecting against a narrow win that damages a different part of the business.

Common Formulas Used as Primary Metrics

Several standard Six Sigma formulas frequently serve as primary metrics across industries.

MetricFormulaCommon Use Case
First pass yield (FPY)(Units passing without rework) ÷ (Total units started)Manufacturing, batch processing
Defects per million opportunities (DPMO)(Number of defects ÷ (Units × Opportunities per unit)) × 1,000,000Process quality benchmarking
Cycle timeTime from process start to process completionService delivery, order fulfillment
Cost per unitTotal process cost ÷ Total units producedCost reduction projects

Common Mistakes When Choosing a Primary Metric

Choosing a metric the team cannot influence. A project measured by company-wide revenue, when the team’s scope only covers one small process step, sets up an impossible standard from day one.

Choosing more than one primary metric. This hides trade-offs instead of forcing the team to confront them directly, and it makes final project results harder to judge cleanly.

Skipping the baseline measurement. Without a documented starting point, a team cannot prove the primary metric actually improved, no matter how good the final number looks.

Confusing a consequential metric with a primary metric. Revenue, market share, and customer lifetime value all sit too far downstream to serve as a project’s direct target, even though they matter to the business.

Changing the primary metric mid-project without documentation. This usually signals the original metric was chosen poorly, and it damages the credibility of the project’s final results.

Why This Matters for Every Stakeholder

The primary metric gives every level of the organization a shared reference point. A line worker, a department manager, and an executive sponsor can all look at the same number and understand whether the process is meeting its target. This shared language is part of why a poorly chosen primary metric causes confusion far beyond the project team itself.

Frequently Asked Questions (FAQs) on Primary Metric in Six Sigma

What is a primary metric in Six Sigma?
A primary metric is the single measurement a Six Sigma project uses to define and prove success. It ties directly to the process output the team is improving, and the team must be able to influence it through their project’s changes.

Can a Six Sigma project have more than one primary metric?
No. A project should have exactly one primary metric. Using multiple primary metrics hides trade-offs between them and makes it unclear whether the project actually succeeded.

What is the difference between a primary metric and a secondary metric?
A primary metric is the core output a project aims to improve. A secondary metric tracks a related factor that should not get worse while the primary metric improves, acting as a guardrail against unintended side effects.

What is a consequential metric?
A consequential metric is a downstream business result, like revenue or customer retention, that a project’s primary metric is expected to eventually influence. It sits too far removed from the team’s direct control to serve as the primary metric itself.

How do you choose a good primary metric?
A good primary metric connects directly to customer or business value, can be directly influenced by the project team, and can be measured consistently and objectively. It should trace directly back to the project’s problem statement.

What is an example of a primary metric?
First pass yield, the percentage of units completed correctly without rework, is a common primary metric in manufacturing. In a service setting, average handle time often serves the same role.

Why is choosing the wrong primary metric a common cause of project failure?
A primary metric that the team cannot influence, that is too vague to measure consistently, or that is actually a consequential metric in disguise sets the project up to fail from the start, regardless of how well the team executes the rest of the DMAIC process.

Final Words

A primary metric earns its name by playing one specific role: it is the single number a project gets judged against, chosen because the team can actually move it and because it matters to the customer or the business.

Confusing it with a secondary metric, which guards against side effects, or a consequential metric, which sits too far downstream to control directly, sets a project up for a confusing or contested outcome. Locking in a well-chosen primary metric, with a documented baseline, inside the project charter from day one gives every stakeholder a shared, defensible way to judge whether the project actually worked.

Build Stronger Project Foundations with SSDSI

Choosing the right primary metric is one of the first decisions that determines whether a Six Sigma project succeeds or stalls. SSDSI delivers IASSC-accredited Green Belt and Black Belt training that covers project chartering, metric selection, and the full DMAIC framework, through onsite, live virtual, public, and self-paced formats.

SSDSI has certified 5,322+ professionals across 600+ organizations in 52 cities, backed by a 5-star Google review rating. If you want to build this foundational skill properly, a conversation about the right certification path is a solid next step.

About Six Sigma Development Solutions, Inc.

Six Sigma Development Solutions, Inc. offers onsite, public, and virtual Lean Six Sigma certification training. We are an Accredited Training Organization by the IASSC (International Association of Six Sigma Certification). We offer Lean Six Sigma Green Belt, Black Belt, and Yellow Belt, as well as LEAN certifications.

Book a Call and Let us know how we can help meet your training needs.
